How to Reduce Product Design Cost Without Losing Quality

Spending way more than you should on product design because of some hidden loopholes? Check here on how to reduce your design costs

November 27, 20228 min read

Konstantin Dolgan

Written by Konstantin Dolgan, Ph.D., NPDP

Founder & CEO, Product Development Engineer

Published November 27, 2022Updated August 19, 2026

Most design budget overruns are not caused by expensive engineers. They are caused by rework - decisions revisited, drawings redone, prototypes rebuilt because requirements moved after work started. Cutting hourly rates saves a few percent. Cutting rework saves a third.

This guide shows where product design money actually goes, seven methods that reduce cost with the trade-off stated for each, and the false economies that raise total cost while appearing to lower it. For full-program budgeting, see new product development cost by phase.

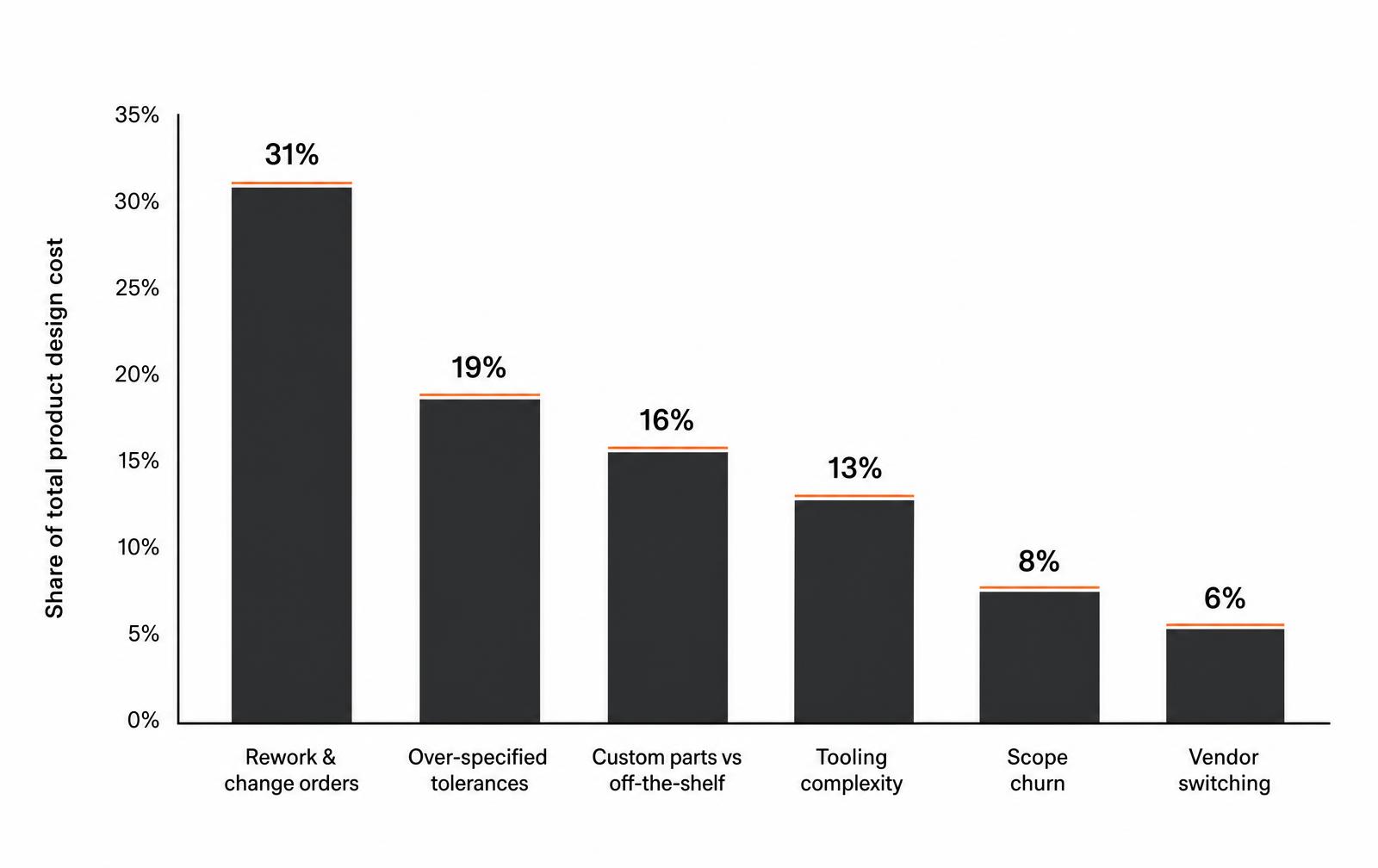

Chart showing the largest drivers of product design cost, led by rework and change orders
Rework and over-specification dominate design spend on most programs.

Where the money actually goes

Cost driver
Typical share of design spend
Root cause
Rework and change orders
About a third
Requirements not frozen before detailed design
Over-specified tolerances and finishes
Roughly a fifth
Defaults copied from a previous project
Custom parts where standards exist
Roughly a sixth
No parts library or standardization review
Tooling complexity
Around an eighth
Geometry that forces side actions and multiple cavities
Scope churn
Under a tenth
Features added mid-phase without a gate
Vendor switching
Small but disruptive
Sourcing chosen on price after design is locked

The pattern matters more than the exact percentages: the largest savings come from decisions made before CAD, not from squeezing the people doing CAD.

Seven methods that actually reduce cost

Method
Typical saving
Trade-off to accept
Freeze requirements before detailed design
15 to 30 percent of design hours
Slower start; a real requirements phase up front
Use off-the-shelf parts wherever function allows
10 to 25 percent of BOM and design time
Less differentiation on non-visible components
Right-size tolerances and surface finishes
5 to 20 percent of part cost
Requires a tolerance stack-up analysis to do safely
Batch design changes into scheduled releases
10 to 20 percent of engineering hours
Non-urgent fixes wait for the next release
Design for manufacture before quoting
10 to 30 percent of tooling and unit cost
Manufacturing input is needed early, not at handoff
Reduce part count through integration
5 to 15 percent of assembly cost
Higher tooling complexity per part; verify it nets out
Prototype only to answer defined questions
20 to 40 percent of prototyping spend
Discipline to skip the impressive-looking build

1. Freeze requirements before detailed design

Every requirement that changes after detailed design begins invalidates drawings, tolerance analysis, supplier quotes and often tooling direction. Write requirements as measurable statements with a named owner, review them with manufacturing and sales, then hold a freeze gate. Changes after the gate go through a change board with a cost estimate attached, which alone eliminates most of them.

2. Use off-the-shelf parts wherever function allows

A custom fastener, bracket or seal costs design time, drawing time, tooling, qualification and supply risk. A catalog equivalent costs a search. Reserve custom geometry for the parts that carry your differentiation - the ones customers see, touch or benefit from - and standardize everything else. Maintain an approved parts library so the second product reuses the first one work.

3. Right-size tolerances and finishes

Tolerance is the most expensive number on a drawing. Tightening a machined dimension by one order of magnitude can double or triple its cost, and cosmetic finish callouts on hidden surfaces waste money silently. Run a stack-up analysis, tighten only the dimensions that control fit or function, and open everything else to standard shop tolerances.

Two or three critical dimensions per part is normal. A drawing where every dimension is tight signals that nobody did the analysis.

4. Batch changes into scheduled releases

Each individual change carries fixed overhead: drawing update, review, revision control, supplier notification, sometimes re-quoting. Ten changes released together cost far less than ten released separately. Keep a running change list, triage weekly, and release on a cadence unless a change blocks a build.

5. Bring manufacturing in before the design is finished

A design for manufacture review at 60 to 80 percent completion typically finds changes that reduce tooling and unit cost by double digits - draft angles, uniform wall thickness, eliminated undercuts, consolidated finishes, better material selection. The same findings after tooling release cost a tool modification instead of a CAD edit. See our manufacturing services for how this review runs in practice.

6. Reduce part count - but verify it nets out

Fewer parts means fewer drawings, fewer suppliers, fewer assembly steps and fewer tolerance interactions. Integration is not always cheaper though: combining three simple molded parts into one complex part with side actions can raise tooling cost more than it saves in assembly. Compare total cost at your real volume before committing.

7. Prototype only to answer defined questions

Every prototype should have a written question and pass criteria. Builds made to look impressive rather than to retire a risk are the most common avoidable line item in a design budget. Match fidelity to the question - see prototyping done right and what prototypes cost.

False economies that raise total cost

Apparent saving
What it actually costs
Skipping the requirements phase
Rework that exceeds the phase you skipped, usually several times over
Choosing the lowest hourly rate
More hours, more revisions, weaker manufacturing judgment
Skipping prototypes to save time
Defects discovered in tooling or in the field
Deferring DFM to the manufacturer
Tool modifications and unit cost locked in by geometry
Cutting testing and validation
Warranty claims, recalls and lost retail relationships
Splitting work across cheap disconnected vendors
Integration failures nobody owns

A practical sequence for a cost-constrained program

  • Write measurable requirements and hold a freeze gate before detailed design.
  • Set a target unit cost at a stated volume and track the BOM against it weekly.
  • Run a standardization pass: which parts can be catalog items?
  • Do a DFM review at 60 to 80 percent design completion with a real manufacturer.
  • Analyze tolerance stacks and open every dimension that does not control fit or function.
  • Plan prototype rounds by the risk each retires, and no more.
  • Batch changes on a weekly release cadence with cost attached to each.

Frequently asked questions

How can I reduce product design costs?

Freeze requirements before detailed design, use off-the-shelf parts where function allows, right-size tolerances after a stack-up analysis, batch changes into scheduled releases, run a design for manufacture review before tooling, consolidate parts where it nets out, and prototype only to answer defined questions. Together these commonly cut design spend by 20 to 40 percent.

What is the biggest driver of product design cost?

Rework caused by late requirement changes. It typically consumes about a third of design spend because each change invalidates drawings, tolerance analysis, supplier quotes and sometimes tooling direction. A requirements freeze gate with costed change control is the highest-leverage fix.

Does cutting design cost hurt product quality?

Not when the savings come from eliminating rework, over-specification and unnecessary custom parts - those changes usually improve manufacturability. Quality suffers when teams cut validation testing, skip prototypes or defer design for manufacture, because those defects surface in tooling or in the field where they cost far more.

How much does tightening a tolerance cost?

Cost rises sharply and non-linearly. Moving a machined feature from a standard shop tolerance to a precision one can double or triple that feature cost through slower machining, added inspection and higher scrap. Most parts need only two or three tightly controlled dimensions.

Is it cheaper to use one design firm or several specialists?

One integrated team is usually cheaper in total for hardware programs. Splitting industrial design, mechanical engineering, electronics and manufacturing across disconnected vendors creates integration gaps that nobody owns, and the rework at those boundaries typically exceeds the rate savings.

Design it once, correctly

LA NPDT scopes programs around the decisions that control cost - requirements, standardization, tolerances and manufacturability - through product design, mechanical engineering and manufacturing support.

Where cost is locked in versus where it is spent

The uncomfortable arithmetic of product design cost is that early decisions commit most of the lifetime cost while consuming very little of the budget. By the time a program is in tooling, the levers that remain are small. Understanding that curve is what makes cost reduction a scheduling decision rather than a negotiation with suppliers.

Cost committed by phase

Phase
Share of budget spent
Share of lifetime cost committed
Levers still available
Concept
5-10%
60-70%
Architecture, part count, technology choice
Detailed design
25-35%
80-85%
Materials, tolerances, process selection
Prototyping and test
15-25%
90%
Design refinements, supplier choice
Tooling and transfer
30-40%
95%+
Cycle time, cavitation, packaging
Production
Ongoing
Locked
Negotiation, yield improvement only

This is why a cost workshop at concept, with a manufacturing engineer present, returns more than months of later supplier negotiation. Spend a week there and the remaining program has a realistic target instead of an aspiration.

Concept-phase cost workshop agenda

  • Set a target BOM cost and a target landed cost before drawing anything.
  • Review the architecture for part count and assembly steps.
  • Choose processes deliberately against volume, not by habit.
  • Identify the three most expensive parts and challenge each requirement behind them.
  • Agree what quality attributes are non-negotiable so later cuts do not touch them.

Key takeaways

  • Concept decisions commit most of the lifetime cost while spending almost none of it.
  • A cost workshop at concept beats supplier negotiation later.
  • Define non-negotiable quality attributes up front so cost cuts stay safe.

What product design cost looks like by product type

Budgets go wrong most often at the estimate, not during execution. The ranges below are what a competent team charges to take a product from validated concept to a documented, manufacturable design — industrial design, engineering, prototypes and manufacturing documentation included, tooling excluded.

Product type
Typical design cost
Main cost driver
Common overrun
Simple moulded consumer product
$15,000-$45,000
Part count and cosmetic finish
Late aesthetic changes after tooling quote
Mechanical product with moving parts
$35,000-$90,000
Tolerance stack and durability testing
Wear failures found in late testing
Connected electronics device
$60,000-$180,000
Firmware, RF performance, certification
Pre-compliance failures and antenna retuning
Medical or regulated device
$120,000-$400,000
Design controls, documentation, verification
Documentation written after the fact
Industrial equipment
$80,000-$250,000
Safety standards and low-volume fabrication
Vendor drawing revisions and site variations

Two rules travel across every row. A quote without a named prototype count is not a quote. And any estimate that excludes at least one full design-for-manufacture iteration will be exceeded, because that iteration always happens — it is only ever a question of who pays for it.

Tracking cost without adding overhead

  • Track spend against phase gates, not against calendar months.
  • Log every change request with its cause; recurring causes are process problems, not bad luck.
  • Re-estimate the remaining work at each gate rather than defending the original number.
  • Keep a target BOM cost on the same page as the design budget; they trade against each other.
  • Review prototype spend monthly and kill builds that have no written question to answer.

Cost-effective product development without cutting quality

Cost-efficient product development comes from removing waste, not from removing engineering. The waste is concentrated in three places: work done twice because a requirement moved, features designed but never validated by a user, and custom parts made where a catalogue part would have done the job. Programs that attack those three routinely finish 20 to 30 percent under a comparable program without any measurable quality loss, because nothing that touches performance was removed.

What does hurt quality is compressing verification. Cutting the test plan saves a few thousand dollars during design and costs a recall, a field retrofit or a returns spike later. Protect testing and standardisation; cut custom parts, speculative features and unnecessary prototype builds instead.

How do you design products to minimize costs?

Set a target cost before drawing, freeze requirements before detailed design, standardise on catalogue components and existing suppliers, keep tight tolerances to the two or three dimensions that need them, and bring a manufacturing engineer into the concept review. Those five habits control most of the lifetime cost while spending almost none of the budget.

Key takeaways on reducing product design cost

  • Estimate by product type and always include one design-for-manufacture iteration.
  • Rework, over-specification and custom parts are where the money leaks.
  • Re-estimate at each gate rather than defending the original number.
  • Never buy savings from the verification plan; that cost reappears in the field.

Where the budget goes, phase by phase

Knowing the total is less useful than knowing the shape. On a typical hardware program, the spend is back-loaded while the decisions are front-loaded, which is exactly why cutting the early phases to save money reliably increases the total.

Phase
Share of design budget
What you are buying
What overspending here usually means
Requirements and research
5-10%
A written, testable definition of done
Nothing — this is the cheapest place to spend
Concept and industrial design
15-25%
Form, user interaction, initial cost target
Too many concepts explored without a selection rule
Engineering and detailed design
30-40%
Drawings, tolerance analysis, BOM
Requirements were never frozen
Prototyping and testing
15-25%
Evidence the design works
Builds made without a written question to answer
Manufacturing documentation
10-15%
A package a supplier can build from
Documentation done twice because the design moved

Read those shares against your own invoices. Engineering above 45 percent almost always signals rework. Prototyping above 30 percent signals builds that were not answering defined questions. And a requirements line near zero predicts both of the above later in the program.

The teams that hit their number are rarely the ones with the cheapest hourly rate. They are the ones who decided what the product had to do before anyone opened CAD, and who priced the whole path rather than the next invoice.

Fixed price or hourly: which contract costs less

The contract shape changes the total as much as the hourly rate does. Fixed price moves risk to the design firm, and the firm prices that risk in — typically 15 to 30 percent above the honest estimate — then defends the scope line by line when anything changes. Hourly keeps the premium out of the number but leaves the overrun risk with you.

  • Use fixed price where scope is genuinely knowable: a defined redesign, a documentation package, a tooling release.
  • Use hourly or phase-capped work for research, concept exploration and troubleshooting, where the scope is the unknown.
  • Split the program: fixed price per phase, re-quoted at each gate, is usually the cheapest honest structure.
  • Insist on a named prototype count and a named change allowance in either structure; both are where quotes hide.
  • Ask what happens when a test fails. A contract with no answer to that question will produce a change order.

Whatever the structure, review spend against phase gates and re-forecast the remainder at each one. A budget that is only compared with its original number at the end tells you nothing while it still could have been fixed.

Need to hit a cost target without losing quality?

Talk to our design team

Work with LA NPDT: if you are moving from here to execution, start with our product design services or talk to us about industrial design and development.

Frequently asked questions

Where the money actually goes?

The pattern matters more than the exact percentages: the largest savings come from decisions made before CAD, not from squeezing the people doing CAD.

How can I reduce product design costs?

Freeze requirements before detailed design, use off-the-shelf parts where function allows, right-size tolerances after a stack-up analysis, batch changes into scheduled releases, run a design for manufacture review before tooling, consolidate parts where it nets out, and prototype only to answer defined questions. Together these commonly cut design spend by 20 to 40 percent.

What is the biggest driver of product design cost?

Rework caused by late requirement changes. It typically consumes about a third of design spend because each change invalidates drawings, tolerance analysis, supplier quotes and sometimes tooling direction. A requirements freeze gate with costed change control is the highest-leverage fix.

Does cutting design cost hurt product quality?

Not when the savings come from eliminating rework, over-specification and unnecessary custom parts - those changes usually improve manufacturability. Quality suffers when teams cut validation testing, skip prototypes or defer design for manufacture, because those defects surface in tooling or in the field where they cost far more.

How much does tightening a tolerance cost?

Cost rises sharply and non-linearly. Moving a machined feature from a standard shop tolerance to a precision one can double or triple that feature cost through slower machining, added inspection and higher scrap. Most parts need only two or three tightly controlled dimensions.

Is it cheaper to use one design firm or several specialists?

One integrated team is usually cheaper in total for hardware programs. Splitting industrial design, mechanical engineering, electronics and manufacturing across disconnected vendors creates integration gaps that nobody owns, and the rework at those boundaries typically exceeds the rate savings.

Where cost is locked in versus where it is spent?

The uncomfortable arithmetic of product design cost is that early decisions commit most of the lifetime cost while consuming very little of the budget. By the time a program is in tooling, the levers that remain are small. Understanding that curve is what makes cost reduction a scheduling decision rather than a negotiation with suppliers.

What product design cost looks like by product type?

Budgets go wrong most often at the estimate, not during execution. The ranges below are what a competent team charges to take a product from validated concept to a documented, manufacturable design — industrial design, engineering, prototypes and manufacturing documentation included, tooling excluded. Two rules travel across every row. A quote without a named prototype count is not a quote. And any estimate that excludes at least one full design-for-manufacture iteration will be exceeded, because that iteration always happens — it is only ever a question of who pays for it.

How do you design products to minimize costs?

Set a target cost before drawing, freeze requirements before detailed design, standardise on catalogue components and existing suppliers, keep tight tolerances to the two or three dimensions that need them, and bring a manufacturing engineer into the concept review. Those five habits control most of the lifetime cost while spending almost none of the budget.

Where the budget goes, phase by phase?

Knowing the total is less useful than knowing the shape. On a typical hardware program, the spend is back-loaded while the decisions are front-loaded, which is exactly why cutting the early phases to save money reliably increases the total. Read those shares against your own invoices. Engineering above 45 percent almost always signals rework. Prototyping above 30 percent signals builds that were not answering defined questions. And a requirements line near zero predicts both of the above later in the program. The teams that hit their number are rarely the ones with the cheapest hourly rate. They are the ones who decided what the product had to do before anyone opened CAD, and who priced the whole path rather than the next invoice.

Related articles

All articles

Get in touch

Tell us about your product idea

Send us a few details and one of our product development experts will get back to you within one business day.

Your information stays confidential and is never shared.
