Prototype Manufacturing Process: Steps, Methods and Lead Times

How a prototype actually gets made: the six steps from CAD release to tested unit, how to pick a process, and what each route costs in time and money.

December 15, 20225 min read

Ralph Hill

Written by Ralph Hill, Mechanical & electrical systems, 3D manufacturing

Prototyping Engineer

Published December 15, 2022Updated August 18, 2026

The prototype manufacturing process turns a released CAD model into a physical unit you can test, show and iterate. Six steps, in order: release the geometry, choose the process, fabricate the parts, finish them, assemble, then test and iterate. Most schedule overruns come from skipping step two and defaulting to whatever machine is free.

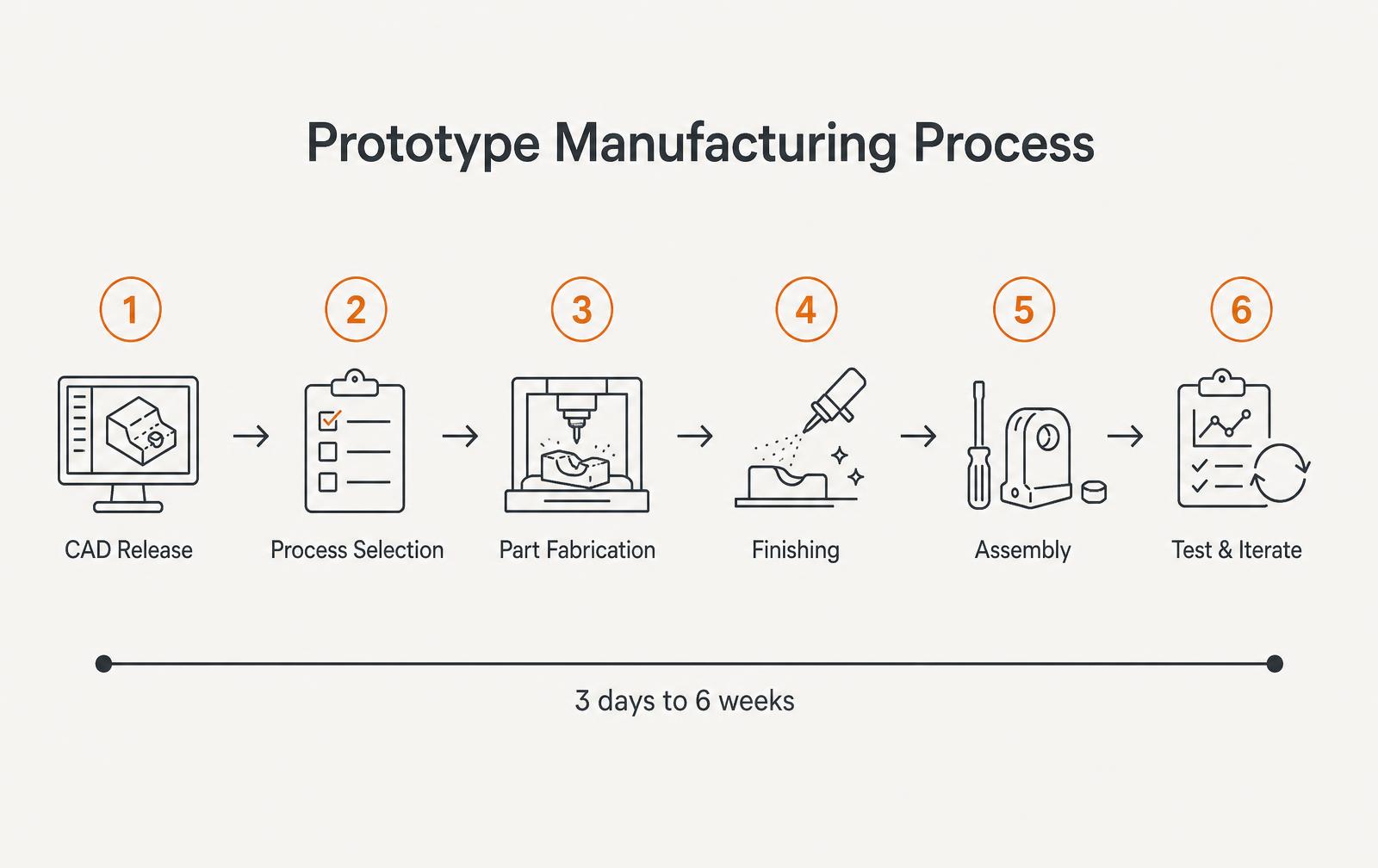

Infographic of the six-step prototype manufacturing process from CAD release through test and iterate with a three-day to six-week timeline
The six steps of prototype manufacturing and the typical end-to-end timeline.

Step 1: Release the CAD

A prototype build starts from a frozen model set: solid geometry, a drawing with critical dimensions and tolerances, material and finish callouts, and a bill of materials for purchased parts. Send STEP for geometry and PDF drawings for intent. Sending only an STL guarantees a part that looks right and fits nothing.

Step 2: Choose the process

Process
Best for
Typical lead time
Typical cost per part
FDM 3D printing
Fit checks, jigs, early form models
1-3 days
$20-$200
SLA / DLP resin
Fine detail, smooth cosmetic parts
2-4 days
$50-$400
SLS nylon
Functional parts, living hinges, snap fits
3-6 days
$80-$600
CNC machining
Load-bearing metal or engineering plastic
5-12 days
$150-$2,500
Urethane vacuum casting
10-50 near-production plastic parts
10-18 days
$60-$400
Sheet metal and tube
Enclosures, brackets, frames
7-14 days
$100-$1,200
Soft or bridge tooling
100-2,000 production-material parts
3-6 weeks
$3-$60 plus tool

Pick by the question the prototype has to answer. If the question is does it fit, print it overnight. If the question is does it survive 10,000 cycles, print nothing - machine it or cast it in the real material, because printed layers fail in ways production parts never will.

Step 3: Fabricate

  • Batch parts by process, not by assembly, so each shop runs one setup.
  • Order long-lead purchased items (motors, displays, seals, custom PCBAs) at the same time as the fabricated parts.
  • Build two of every critical part. The second one costs 20% more and saves a week when the first is damaged in testing.
  • Ask for in-process photos on machined parts so surprises appear before shipping.

Step 4: Finishing

Finishing is where prototypes gain or lose credibility. Sanding, priming and painting a printed part adds 2-5 days and $60-$400 per part but turns a visibly layered model into something you can put in front of a buyer. Functional parts often need bead blasting, anodizing, heat-set inserts or thread repair instead - cosmetic effort there is wasted money.

Step 5: Assembly

Dry-fit everything before adhesives or permanent fasteners. Record actual fits against nominal so the CAD gets corrected rather than the part getting filed down and forgotten. On electromechanical units, bench-test the electronics outside the housing first; debugging a fault inside a sealed enclosure costs a day.

Step 6: Test and iterate

Prototype round
Purpose
Typical duration
Typical cost
Looks-like
Form, size, ergonomics, buyer reaction
1-2 weeks
$1,500-$8,000
Works-like
Core function proven, cosmetics ignored
2-4 weeks
$5,000-$30,000
Integrated alpha
Function and form in one unit
4-8 weeks
$15,000-$80,000
Beta / pilot
Production materials and processes
6-12 weeks
$30,000-$150,000

Two to four rounds is normal for a consumer electromechanical product. Programs that claim one round either had a very simple part or discovered the missing rounds later, at tooling. Our rapid prototyping team runs these rounds in-house and hands the result to low volume manufacturing when the design holds.

How to compress the schedule without wrecking it

  • Split the build: print the non-critical shell while the critical metal part is machined.
  • Freeze interfaces early - mounting points, connectors, board outline - and let cosmetics keep moving.
  • Use standard fasteners and stock material sizes; custom stock adds a week for nothing.
  • Keep one supplier accountable for the assembled unit rather than coordinating five shops yourself.
  • Design test fixtures in parallel with the parts, not after they arrive.

What investors are actually testing at each prototype stage

A prototype raises money when it retires a specific risk an investor is worried about. A beautiful appearance model does nothing for a fund that is worried about manufacturability, and a rat's-nest breadboard does nothing for a consumer brand investor worried about whether people want the thing. Match the artifact to the doubt.

Prototype
Risk it retires
Typical cost
Time
Right audience
Looks-like model
Will anyone want it?
$2k–$12k
1–3 weeks
Consumer, retail buyers
Works-like rig
Does the physics work?
$5k–$40k
3–8 weeks
Technical diligence
Integrated alpha
Can it be one product?
$25k–$120k
8–16 weeks
Seed and Series A
Engineering validation (EVT)
Can it be made repeatably?
$60k–$250k
12–20 weeks
Growth investors
Pilot production run
Can unit cost hold?
$100k–$500k
16–28 weeks
Debt, retail commitments

The metrics that travel with the prototype

  • Measured bill of materials at a stated quantity, with the three line items that dominate it named.
  • Test data, not adjectives: cycles to failure, runtime, accuracy, drop survival at a stated height.
  • A named manufacturing path — process, likely region, tooling estimate and lead time.
  • Regulatory path with the specific standards that apply and what they cost to satisfy.
  • User evidence: how many people used it unassisted, and what fraction completed the core task.
  • The next milestone the money buys, with a date and a definition of done.

How much of a raise a prototype should consume

A common failure pattern is spending the entire pre-seed on a single polished demo unit and having nothing left for the design-for-manufacture work that follows. As a rough allocation for a hardware pre-seed or seed: 30–40% engineering and prototyping, 15–20% tooling deposits and manufacturing engineering, 15% testing and certification, 10% inventory deposits, and the rest runway. If the prototype budget exceeds half the raise, either the prototype is too ambitious for the stage or the raise is too small.

Common diligence questions to prepare for

  • What in this unit is hand-made, and what changes when it is made in a tool?
  • Which supplier is single-sourced, and what happens if they quote a 30-week lead time?
  • What is the warranty return rate you are assuming, and where does the number come from?
  • What does the second version cost, and how much of this design survives into it?
  • Who owns the IP created by your contractors, and is that in writing?

If you are heading into a raise, our rapid prototyping services are usually scoped around the specific risk your investors have named.

Frequently asked questions

How long does the prototype manufacturing process take?

A single printed part can be in hand in 1-3 days. A complete assembled functional prototype typically takes 3-6 weeks, and a pilot-grade unit built with production materials takes 6-12 weeks.

How much does a prototype cost to manufacture?

Simple printed or machined parts run $20-$2,500 each. A complete functional prototype of a consumer electromechanical product usually lands between $5,000 and $30,000 per round, including parts, electronics, finishing and assembly.

What files does a prototype shop need?

Send STEP files for geometry, a dimensioned PDF drawing with tolerances and critical features, material and finish specifications, quantity, and a bill of materials for purchased components. STL alone is only adequate for a rough form model.

Should a prototype use production materials?

Only when the test requires it. Form and fit rounds are fine in printed resin or nylon. Any test of strength, fatigue, chemical resistance, or regulatory performance must use the production material and, ideally, the production process.

The prototype manufacturing process, stage by stage

Prototyping is a sequence of increasingly expensive answers to increasingly specific questions. A looks-like model answers whether people want it. A works-like rig answers whether the physics holds. An engineering prototype answers whether the assembly and the electronics behave together, and a production-intent unit answers whether the factory can build it repeatedly. Skipping a stage does not save money; it moves the discovery to the stage where changes cost ten times more.

Prototyping shop floor with resin and filament 3D printers running while a technician finishes machined aluminum parts at a bench
Stage
Purpose
Method
Lead time
Cost range
Concept model
Form, size, ergonomics
FDM or SLA print, foam
2-5 days
$300-$2.5k
Works-like rig
Core function on the bench
Off-the-shelf parts, dev boards
1-3 weeks
$2k-$15k
Engineering prototype
Integrated mechanics and electronics
SLA/SLS housings, machined parts, custom PCB
3-6 weeks
$8k-$45k
Production-intent
Real materials and processes
Bridge tooling, cast urethane, sheet metal
5-10 weeks
$15k-$80k
Pilot run
Process capability and yield
Soft or hard tooling, 50-500 units
8-16 weeks
$30k-$250k

Choosing a process for the question you are asking

  • SLA - best surface finish for appearance models and clear parts; brittle and UV sensitive, so not for functional load testing.
  • SLS nylon - tough functional parts with living hinges and snap fits; grainy finish.
  • CNC machining - real engineering materials and true tolerances when you need to test fit and strength.
  • Cast urethane - 25-200 units in production-like plastics from a silicone tool in 2-3 weeks.
  • Bridge (aluminum) tooling - real injection molded parts in 3-5 weeks at a third the cost of steel, good for 5,000-20,000 shots.
  • Sheet metal and extrusion - fast, low tooling, and often the right answer for enclosures nobody will see.

What investors want to see in a prototype

Investors are not buying craftsmanship; they are buying reduced risk. A prototype that demonstrates the single hardest technical claim - the sensor accuracy, the runtime, the cycle life - retires more risk than a beautiful housing. Pair the demo with a costed bill of materials, a DFM review from a real factory, and a test report. That package converts a pitch from a story into a schedule.

  • Key takeaway 1: Each prototype stage should answer one defined question.
  • Key takeaway 2: Match the process to the question - appearance, function, tolerance, or process capability.
  • Key takeaway 3: Bridge tooling delivers production-like parts long before steel is justified.
  • Key takeaway 4: A costed BOM and a test report make a prototype fundable.

Machining, printing, casting, electronics and assembly under one roof, with one team accountable for the finished unit.

Talk to an expert

Frequently asked questions

How to compress the schedule without wrecking it?

Split the build: print the non-critical shell while the critical metal part is machined.. Freeze interfaces early - mounting points, connectors, board outline - and let cosmetics keep moving.. Use standard fasteners and stock material sizes; custom stock adds a week for nothing.. Keep one supplier accountable for the assembled unit rather than coordinating five shops yourself.. Design test fixtures in parallel with the parts, not after they arrive.

What investors are actually testing at each prototype stage?

A prototype raises money when it retires a specific risk an investor is worried about. A beautiful appearance model does nothing for a fund that is worried about manufacturability, and a rat's-nest breadboard does nothing for a consumer brand investor worried about whether people want the thing. Match the artifact to the doubt.

How much of a raise a prototype should consume?

A common failure pattern is spending the entire pre-seed on a single polished demo unit and having nothing left for the design-for-manufacture work that follows. As a rough allocation for a hardware pre-seed or seed: 30–40% engineering and prototyping, 15–20% tooling deposits and manufacturing engineering, 15% testing and certification, 10% inventory deposits, and the rest runway. If the prototype budget exceeds half the raise, either the prototype is too ambitious for the stage or the raise is too small.

How long does the prototype manufacturing process take?

A single printed part can be in hand in 1-3 days. A complete assembled functional prototype typically takes 3-6 weeks, and a pilot-grade unit built with production materials takes 6-12 weeks.

How much does a prototype cost to manufacture?

Simple printed or machined parts run $20-$2,500 each. A complete functional prototype of a consumer electromechanical product usually lands between $5,000 and $30,000 per round, including parts, electronics, finishing and assembly.

What files does a prototype shop need?

Send STEP files for geometry, a dimensioned PDF drawing with tolerances and critical features, material and finish specifications, quantity, and a bill of materials for purchased components. STL alone is only adequate for a rough form model.

Should a prototype use production materials?

Only when the test requires it. Form and fit rounds are fine in printed resin or nylon. Any test of strength, fatigue, chemical resistance, or regulatory performance must use the production material and, ideally, the production process.

What investors want to see in a prototype?

Investors are not buying craftsmanship; they are buying reduced risk. A prototype that demonstrates the single hardest technical claim - the sensor accuracy, the runtime, the cycle life - retires more risk than a beautiful housing. Pair the demo with a costed bill of materials, a DFM review from a real factory, and a test report. That package converts a pitch from a story into a schedule. Key takeaway 1: Each prototype stage should answer one defined question.. Key takeaway 2: Match the process to the question - appearance, function, tolerance, or process capability.. Key takeaway 3: Bridge tooling delivers production-like parts long before steel is justified.. Key takeaway 4: A costed BOM and a test report make a prototype fundable.
