Product Launch Timeline: How Long a Launch Really Takes

What a realistic product launch timeline looks like week by week, what a two-week launch can actually include, and the delays that wreck launch dates.

June 15, 20208 min read

Konstantin Dolgan

Written by Konstantin Dolgan, Ph.D., NPDP

Founder & CEO, Product Development Engineer

Published June 15, 2020Updated September 2, 2026

A product launch timeline is not the same as a development timeline. Launch is the set of activities that happen once the product exists — positioning, pricing, packaging, compliance evidence, inventory, channel setup and demand building. Run in parallel, that is roughly sixteen weeks for a physical product. Run sequentially, it becomes nine months and a missed season.

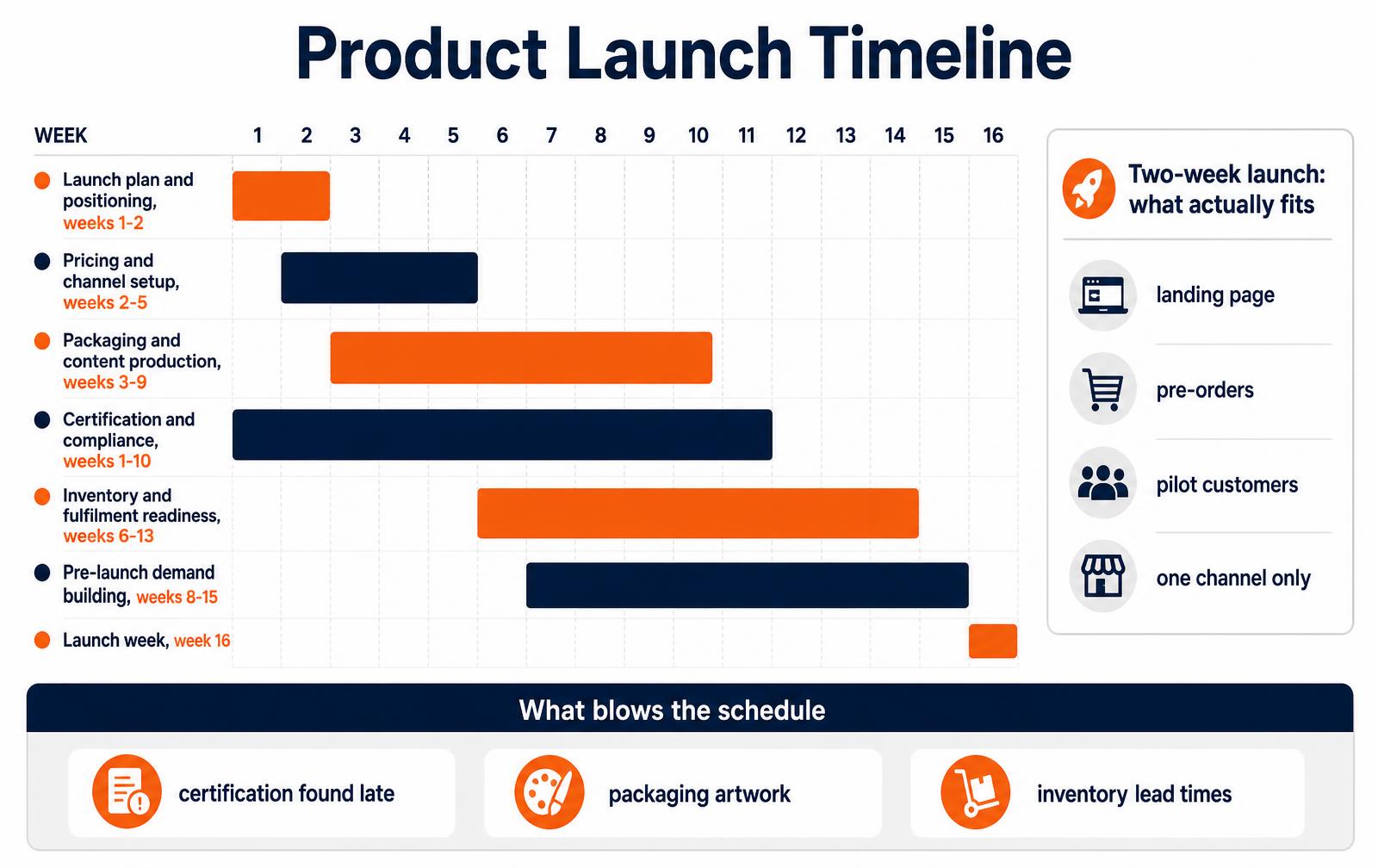

Gantt chart of a 16-week product launch timeline covering launch planning, pricing, packaging, certification, inventory readiness, pre-launch demand building and launch week
A 16-week launch plan with parallel workstreams, and what fits into a two-week launch.

The 16-week launch, week by week

Workstream
Weeks
Owner
Gate to pass
Launch plan and positioning
1-2
Product marketing
One agreed sentence about who it is for
Pricing and channel setup
2-5
Commercial
Margin holds at landed cost plus fees
Packaging and content production
3-9
Design and marketing
Artwork approved against final dimensions
Certification and compliance
1-10
Engineering
Test reports in hand, labels correct
Inventory and fulfilment readiness
6-13
Operations
First units received and inspected
Pre-launch demand building
8-15
Marketing
A waitlist or pipeline large enough to matter
Launch week
16
Everyone
Support, returns and restock plans live

What you can actually launch in two weeks

A great deal, as long as you are honest about what "launch" means. In two weeks a small team can put up a landing page with real positioning, take pre-orders or deposits, run a pilot with a handful of named customers, and sell through exactly one channel.

What does not fit into two weeks is certification, tooled packaging, retail listings or stocked inventory. Launching the commercial test early and the physical supply chain later is a legitimate strategy — pretending the second half does not exist is not.

  • Days 1-3. Positioning, price point, and the single customer segment you are addressing.
  • Days 4-7. Landing page, photography or renders, and a payment or deposit path that works.
  • Days 8-11. Outreach to an existing list, partners or communities where that segment already gathers.
  • Days 12-14. Open orders, measure conversion, and decide whether to fund the full launch.

What blows the schedule

Delay
Typical cost in weeks
How to avoid it
Certification discovered late
6-16
Identify applicable standards during design, not before shipping
Packaging artwork rework
2-6
Freeze product dimensions before artwork starts
Component or inventory lead times
4-12
Place long-lead orders against the design freeze, not the launch date
Failed first article inspection
3-8
Inspect a pilot run before committing to full production
No demand pipeline at launch
Indefinite
Start building the list eight weeks out, not at launch

Two of those — certification and lead times — start during engineering, which is why launch planning belongs in the development schedule rather than after it. Our development process maps where each launch dependency begins, and consulting engagements can run the launch plan alongside the build.

Frequently asked questions

How long does a product launch take?

For a physical product, plan roughly sixteen weeks from launch planning to launch week with workstreams running in parallel: positioning and pricing in weeks one to five, packaging and content in weeks three to nine, certification across weeks one to ten, inventory readiness weeks six to thirteen, and demand building weeks eight to fifteen. Software or service launches compress to four to eight weeks.

Can you launch a product in two weeks?

You can launch a commercial test in two weeks: positioning, a landing page, pre-orders or deposits, a pilot group and one sales channel. You cannot complete certification, tooled packaging, retail listings or stocked inventory in that window. Treat the two-week version as a demand test that funds the full launch.

What usually delays a product launch?

The three most common delays are certification requirements discovered late, which costs six to sixteen weeks. Packaging artwork rework caused by unfrozen product dimensions, two to six weeks. And component or inventory lead times, four to twelve weeks. A failed first article inspection and an empty demand pipeline at launch are close behind.

What can be compressed and what cannot

Every product launch timeline is a negotiation between things governed by decisions and things governed by physics, queues and regulators. Decisions can be made in a morning. Steel cannot be cut faster than the tool shop's queue, certification labs have their own calendars, and ocean freight takes the time it takes. Compressing a launch means attacking the first category ruthlessly and planning honestly around the second.

Activity
Governed by
Compressible?
Realistic floor
Positioning and messaging
Decisions
Yes
2-3 days
Packaging design
Decisions plus print queue
Partly
1-2 weeks
Photography and content
Sample availability
Yes if samples exist
1 week
Injection tooling
Tool shop queue and steel
Barely
4-8 weeks
Regulatory certification
Lab calendar
Only by paying for expedite
3-8 weeks
Ocean freight
Physics
No, air freight instead
4-6 weeks
Retail set date
Buyer's calendar
No
Fixed
Listing and storefront build
Decisions
Yes
2-3 days

When a two-week launch is actually possible

A genuinely fast launch is achievable when the product already exists in a saleable state and what is being launched is the commercial layer: a new variant of an existing platform, a bundle, a regional expansion, or a direct-to-consumer launch of something previously sold only through a channel. The compression comes from having nothing left to manufacture or certify.

  • Inventory is already in the destination market, or drop-ships from existing stock.
  • Certification covers the configuration being sold, with no changes to the radio, power supply or enclosure.
  • Packaging exists, or the product ships in neutral packaging with a printed insert.
  • Support content can be adapted from an existing product's documentation.
  • The launch channel is owned — your store and your list — rather than a retailer's calendar.

A two-week compressed launch plan

Day
Workstream
Output
1
Positioning lock
One-page message hierarchy and target buyer
2
Pricing and offer
Price, bundle, launch incentive, margin check
3-4
Photography and video
Hero shots, in-use set, 30-second demo
4-5
Storefront build
Product page, variants, shipping rules, tax setup
5
Support readiness
FAQ, returns policy, warranty terms, ticket macros
6-7
Content assets
Email sequence, three social cuts, launch post
8
Operations dry run
Test order placed, picked, shipped and returned
9
Soft launch
Page live to list segment, monitor conversion
10-11
Fix and iterate
Copy and page fixes from soft-launch data
12
Full announcement
List, social, partners, paid launch
13-14
Monitor and respond
Daily conversion, support volume, stock burn

Readiness gates worth keeping even under pressure

Speed is bought by cutting sequential dependencies, not by cutting verification. These gates cost hours and prevent the failures that turn a fast launch into a refund event.

Gate
Check
Why it stays
Order-to-delivery test
One real order shipped and received
Catches tax, shipping and packing errors
Returns test
One return processed end to end
Catches label and restocking gaps
Compliance confirmation
Certificates match the shipping configuration
A mismatch is a stop-sale, not a fix
Content accuracy
Specs on page match the physical product
Spec errors drive returns and chargebacks
Support load estimate
Expected tickets per hundred orders
Prevents a queue that eats the launch
Stock and reorder math
Days of cover at forecast rate
Avoids a stockout at peak attention

Where compressed launches actually break

  • Payment and tax configuration untested in the destination market, so orders fail at checkout on day one.
  • Photography shot on pre-production samples that differ visibly from shipped units.
  • Shipping rates set from guesswork, quietly consuming the entire margin on heavy items.
  • Support inbox unmonitored over the first weekend, turning solvable issues into public reviews.
  • Inventory allocated to a marketplace and the direct store simultaneously, with no shared stock counter.
  • A demo video showing a feature that shipped disabled in firmware.

What a normal hardware launch timeline looks like

For context, when the product still needs to be made, the honest schedule from design freeze looks like this. Teams that promise two weeks in this situation are usually not counting the same activities.

Phase
Duration
Runs in parallel with
Design freeze to tooling kickoff
1-2 weeks
Packaging design
Tool build
5-8 weeks
Certification prep, content
First article and tuning
2-4 weeks
Photography on T1 parts
Certification testing
3-8 weeks
Retail listing build
Pilot production
2-3 weeks
Support content, training
Production run
3-5 weeks
Channel loading
Freight and customs
4-6 weeks ocean
Pre-launch marketing
Total from freeze
5-8 months
-

More questions teams ask

Can you really launch a hardware product in two weeks?

Only when manufacturing and certification are already complete. Two weeks is enough to build the commercial layer — pricing, page, content, support and operations — around inventory that exists. It is never enough to make and certify something new.

What is the single biggest schedule risk in a fast launch?

Untested operations. Checkout, tax, shipping rates and returns fail quietly and only under real orders, so a live test order and a live test return are non-negotiable regardless of how compressed the plan is.

Should we soft launch first?

Yes. Even a two-day soft launch to a list segment surfaces page, pricing and fulfilment problems while the audience is small and forgiving, and it produces conversion data that improves the full announcement.

How much inventory should be on hand at launch?

Enough for the forecast plus the reorder lead time, at minimum. Running out during the attention peak is more damaging than carrying extra stock, because the traffic does not come back a second time.

What should be cut first when time runs short?

Breadth, not quality. Launch in one channel, one region, one configuration, done properly — then expand. Cutting verification to preserve scope is the trade that produces recalls and refunds.

We build launch schedules against certification, tooling and lead-time realities, so the date survives the first supplier quote.

Talk to us

What each launch phase actually consumes

Phase
Typical duration
Long pole
Can it be compressed?
Launch plan and positioning
1-2 weeks
Agreement on the single claim
Yes, with a decision owner
Packaging and label artwork
2-4 weeks
Legal and compliance review
Partly - start during DVT
Photography and content
2-3 weeks
Sample availability
Yes, shoot pre-production units
Listing build and channel setup
1-2 weeks
Marketplace category approvals
Rarely
Certification and test reports
3-8 weeks
Lab queue and retests
No - book the slot early
First production run
4-8 weeks
Component lead times
No
Freight and inbound
2-6 weeks
Ocean versus air decision
Yes, at a cost
Soft launch and review seeding
2-3 weeks
Reviewer turnaround
Partly

A launch measured in two weeks is almost always a launch of the announcement, not of the product. The physical chain - certification, production, freight - sets the floor, and no amount of marketing parallelism moves it. What a compressed schedule really buys you is overlap: running artwork, content and channel setup alongside the build instead of after it.

The two-week launch: when it is genuinely possible

  • Inventory is already in the destination warehouse and has passed incoming inspection.
  • Certification is complete and the reports are in hand, not pending.
  • Packaging is printed and the artwork carries the final regulatory marks.
  • You are launching into an existing channel with an approved seller account and category.
  • The product is a variant of something you already sell, so the content template exists.
  • Support has an answer script and a returns policy for the new SKU.

A realistic 16-week schedule

Week
Milestone
Owner
1-2
Positioning locked, pricing and margin approved
Product lead
2-5
Packaging artwork, compliance marks, barcode assignment
Design and regulatory
3-8
Certification testing booked and executed
Regulatory
4-6
Photography and video from pre-production units
Marketing
6-12
Production run, in-line QC, packout
Operations
10-12
Listings built, channel assets uploaded, pricing staged
Ecommerce
12-15
Freight, customs, inbound to fulfilment
Logistics
15-16
Soft launch, review seeding, paid switched on
Marketing

Publish this schedule with named owners and one weekly checkpoint. Most missed launch dates trace back to a task nobody owned - barcode assignment, a missing test report, or artwork waiting on a legal sign-off - rather than to a manufacturing failure. See our product development process guide for how launch planning connects back to the design gates that precede it.

Launch readiness meeting with packaged product samples, carton mockups and a wall planning calendar

Launch readiness checklist

  • Certification reports filed and the certificate numbers printed where required.
  • Barcodes assigned, registered and scanned against live inventory.
  • Listing copy proofed against the claims you can substantiate.
  • Returns, warranty and support workflow live before the first order ships.
  • Spare parts and packaging replenishment ordered with the first run, not after it.
  • A rollback plan for the first quality escape, including who can pause the listing.

Where launch schedules slip most often

Slip
Typical delay
Early warning sign
Preventive action
Certification retest after a failure
3-6 weeks
Pre-compliance skipped
Run pre-compliance during DVT
Packaging artwork rework
2-3 weeks
No named regulatory reviewer
Freeze claims before artwork starts
Component shortage at build
4-12 weeks
Single-sourced long-lead part
Buy long-lead parts at design freeze
Marketplace listing rejection
1-3 weeks
New category, no prior approval
Open the category weeks before launch
Freight and customs hold
1-4 weeks
Incomplete commercial documents
Pre-clear paperwork with the broker
Content shot from the wrong sample
2 weeks
Photography before the cosmetic freeze
Shoot only post-freeze units

Nearly all of these have the same structural cause: a serial dependency that nobody flagged as a critical path item. Build the schedule backwards from the ship date, mark the tasks that cannot start until another finishes, and protect those with a named owner and a weekly status. Everything else can float.

Soft launch before full launch

A soft launch of a few hundred units into one channel buys information that no amount of internal testing produces: how customers describe the product in their own words, which parts of the listing they ignore, what they contact support about, and whether the packaging survives the real shipping network. Two to three weeks of that data will change your copy, your FAQ and often your accessory strategy before you spend money on paid acquisition.

  • Ship to a limited region or a single channel so quality issues stay containable.
  • Instrument support: tag every contact by reason and review the tags weekly.
  • Read the first fifty reviews line by line and rewrite the listing against them.
  • Photograph returned units before restocking; damage patterns reveal packaging faults.
  • Hold at least 15 percent of the run back so you can correct before the main push.
  • Only turn paid spend on once return rate and support volume are stable for a week.

Treated this way, a launch stops being a single date and becomes a sequence of decisions with evidence behind each one. The calendar still matters, but the teams that win the second year are the ones that used the first eight weeks of real customer contact to fix the product and the story rather than to defend the original plan.

Frequently asked questions about launch timing

How long does a product launch take from finished design? For a physical consumer product with tooling already cut and certification complete, twelve to sixteen weeks is a realistic window from design freeze to first customer shipment. If certification and the first production run still lie ahead, plan on five to seven months and treat anything shorter as a stretch case that depends on every supplier hitting their quote.

What is the single biggest lever on launch speed? Ordering long-lead components at design freeze rather than after the first article inspection. Electronics, custom motors, batteries and specialty fasteners routinely carry lead times longer than the entire rest of the launch plan, and buying them early converts a schedule risk into an inventory risk you can quantify.

Should marketing start before the product is finished? Positioning and audience work should start early, because they influence packaging and claims. Photography, paid campaigns and hard launch dates should not - each one written against a design that later changes has to be redone, and the rework usually costs more than the wait would have.

How much inventory should the first run carry? Enough to cover roughly eight to twelve weeks of conservative demand plus warranty replacements, and no more. First runs almost always reveal a change worth making, and a large opening order locks you into shipping the version you already know how to improve.

Work with LA NPDT: if you are moving from here to execution, start with our new product marketing or talk to us about market research.

Related articles

All articles

Get in touch

Tell us what this is about

Share a few details about your question, partnership, or idea — a member of the LA NPDT team will reply within one business day.

Optional context

What are you looking to accomplish? (optional)

What do you already have? (optional — tick any)

Your information stays confidential and is never shared.
