Benefits of Reshoring: When Bringing Production Home Pays Off
Reshoring is not patriotism, it is arithmetic. When you price landed cost honestly, a surprising share of programs come home on the numbers alone.
October 23, 20256 min read

Written by Konstantin Dolgan, Ph.D., NPDP
Founder & CEO, Product Development Engineer
Published October 23, 2025Updated September 2, 2026
The main benefits of reshoring are shorter lead times, lower freight and tariff exposure, tighter quality control, stronger IP protection, less cash tied up in in-transit inventory, and much faster design iteration. The catch is that reshoring only pays when you compare total landed cost, not unit price — which is exactly the comparison most sourcing decisions skip.

Why unit price is the wrong comparison
An overseas quote is a factory-gate price. The cost you actually carry includes everything between that gate and a sellable unit in your warehouse.
Cost element | Typically included in an offshore quote? | Real impact |
|---|---|---|
Unit price | Yes | The number everyone compares |
Ocean or air freight | No | 2 to 15 percent of landed cost |
Duties and tariffs | No | 0 to 25 percent+ depending on HTS code |
In-transit inventory carrying | No | 30 to 60 days of cash at 8 to 20 percent annual |
Safety stock for lead-time variance | No | Often the single largest hidden cost |
Quality escapes, sorting, rework | No | Lumpy and hard to forecast |
Travel, translation, oversight | No | $10,000 to $60,000 per year for an active program |
Tooling risk and IP exposure | No | Difficult to price until it happens |
Add those lines and the gap narrows. For products with high shipping volume, high mix, frequent design changes or short demand cycles, the gap often closes entirely.
The six benefits, quantified
- Lead time. Domestic lead times of 2 to 5 weeks replace 10 to 18 weeks door-to-door. Every week removed cuts safety stock and forecast risk.
- Freight and tariffs. Bulky, low-density products pay the most to ship. Reshoring removes ocean freight volatility and tariff exposure from the P&L.
- Quality control. A one-day drive to the plant changes escalation from a three-week email chain to an afternoon.
- IP protection. Domestic contracts are enforceable in domestic courts, and tooling stays where you can repossess it.
- Working capital. Shorter pipelines free cash; a company holding 90 days of inventory that moves to 35 typically releases meaningful working capital in the first year.
- Iteration speed. Engineering changes land in weeks instead of quarters, which matters most in the first two years of a product's life.
When offshore manufacturing still wins
Reshoring is not universally correct. Be honest about the cases where it is not.
- Labor-dominant assembly with hundreds of manual steps and stable, high-volume demand.
- Mature, unchanging designs where iteration speed has no value left.
- Supply-chain gravity — some component ecosystems, particularly in consumer electronics, are physically clustered overseas.
- Serving overseas markets — building near the customer is the point of localization, as covered in product localization.
- No domestic capability for a specialized process at your volume.

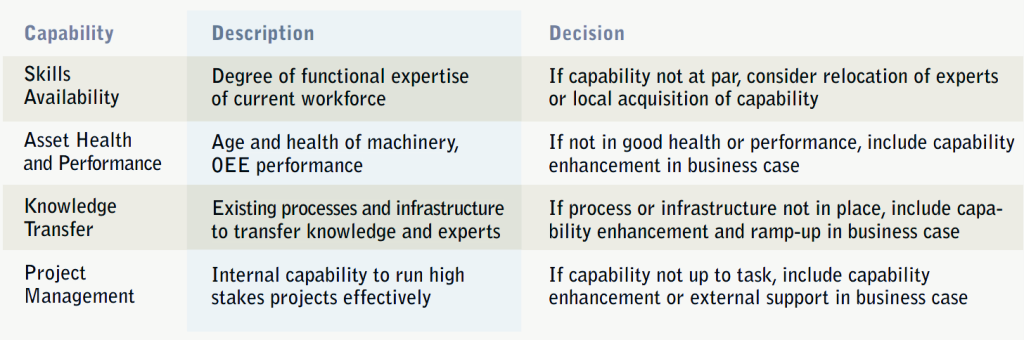

A practical reshoring plan
- Model total landed cost for the current supply chain, including carrying cost and quality escapes. Use 12 months of actuals, not the original quote.
- Segment the portfolio. Reshore the high-mix, high-freight, fast-changing SKUs first; leave the stable commodity items offshore.
- Re-engineer for domestic processes. A design optimized for cheap manual labor is rarely optimal for automated domestic production — see tooling economics.
- Qualify two suppliers, not one, and audit quality systems before pricing.
- Plan tooling transfer or rebuild. Existing tools may be worn, undocumented or contractually stuck; budget for new steel.
- Run a pilot lot and compare first-pass yield, not just price.
- Check incentives. State and federal programs, workforce training grants and accelerated depreciation change the payback math materially.
Typical payback
Program type | Transfer cost | Typical payback |
|---|---|---|
Assembly only, existing parts | $10,000 to $50,000 | 6 to 12 months |
Injection molded product, tool transfer | $25,000 to $150,000 | 12 to 24 months |
Injection molded product, new tooling | $60,000 to $400,000 | 18 to 36 months |
Electronics with domestic PCBA | $40,000 to $200,000 | 12 to 30 months |
Payback compresses fast when tariffs rise or freight spikes, which is why reshoring analyses should be refreshed annually rather than treated as a one-time decision.
Common mistakes
- Comparing quotes instead of landed cost. The most common and most expensive error.
- Reshoring the whole portfolio at once. Start with the SKUs where the benefits are largest.
- Assuming the design transfers unchanged. Different processes, different DFM.
- Ignoring supplier capacity. Domestic shops fill up; qualify early.
- Underestimating the ramp. First-pass yield at a new plant is never day-one perfect.
Total cost of ownership, line by line
Cost element | Offshore | Domestic | Why it moves |
|---|---|---|---|
Unit price | Lower | Higher | Labor and overhead rates |
Ocean or air freight | $0.40-$3.00 per unit | Near zero | Container rates and volumetric weight |
Duties and tariffs | 0-25%+ | None | HTS classification and trade policy |
Inventory in transit | 30-60 days of cash | 3-7 days | Working capital tied to transit |
Safety stock | 8-12 weeks | 2-4 weeks | Lead time variability |
Quality escapes | Higher | Lower | Distance from the line and inspection lag |
Travel and oversight | $8,000-$30,000 per year | Minimal | Site visits and audits |
Engineering change cycle | 4-10 weeks | 1-3 weeks | Communication and shipping loops |
IP exposure | Higher | Lower | Enforcement environment |

A staged reshoring plan
- Pick one high-mix, low-volume SKU as the pilot — the one where lead time hurts most.
- Quote three domestic suppliers with a complete data package, including inspection criteria.
- Run a first article and a capability study before releasing any production quantity.
- Dual-source for one full cycle, holding the offshore line as the fallback.
- Move the tooling only after the domestic line has shipped two conforming lots.
- Recalculate total cost with actuals and decide the next SKU on data, not on the original model.
Key takeaways
- Compare landed, carried and change-cycle costs — never unit price alone.
- Reshoring pays fastest on high-mix, low-volume, frequently revised products.
- Pilot one SKU, dual-source through a full cycle, then move tooling.
- Re-baseline the model with actual costs before scaling the transfer.
How tariffs, freight and lead time change the payback math
Reshoring arithmetic is not stable. The same product can look 18 percent more expensive to build domestically in one quarter and cost-neutral two quarters later, because three of the inputs move independently: duty rates on the HTS code, container spot rates, and the working capital tied up in a 10 to 18 week pipeline. Teams that treat the analysis as a one-time spreadsheet get the answer that was true on the day they built it.
The practical fix is a model with named variables rather than a fixed comparison. Keep unit price, freight per unit, duty percentage, carrying cost of in-transit and safety stock, quality escape cost and expedite spend as separate lines, then re-run the model with your actual twelve-month numbers each year. The table below shows how far the break-even moves across a realistic range for a $12 factory-gate consumer product.
Scenario | Offshore landed cost / unit | Domestic cost / unit | Verdict |
|---|---|---|---|
Low tariff (0%), low freight, stable design | $13.40 | $16.80 | Stay offshore |
Tariff 10%, normal freight | $15.10 | $16.80 | Offshore, but the margin is thin |
Tariff 25%, normal freight | $18.10 | $16.80 | Reshore |
Tariff 10%, freight spike, 4 revisions/year | $19.60 | $17.40 | Reshore |
High-mix, low-volume, air freight on shortfalls | $22.00+ | $17.40 | Reshore first |
Two lines dominate the swing: duty and expedite. Products with volatile demand pay air freight several times a year to cover forecast misses, and that single line often exceeds the entire unit-price advantage. Products with frequent engineering changes pay again in obsolete inventory sitting on a boat. Both problems are structural to distance, not to any particular supplier.
Qualifying a domestic supplier without losing a quarter
The transfer itself, not the decision, is where reshoring programs stall. Domestic shops are quoting the same drawings offshore shops interpreted loosely for years, and the differences surface as first-article failures. Run qualification as a defined sequence with exit criteria rather than as a series of emails.
- Release the data package first. Revision-controlled STEP and 2D drawings with datums, tolerances, critical-to-function dimensions and an inspection plan. Anything the offshore supplier learned by habit has to be written down.
- Quote three shops on identical scope, including inspection, packaging and any secondary operations. A quote that excludes finishing is not cheaper, only shorter.
- Run a capability study (Cpk of 1.33 or better on critical dimensions) on the first 30 parts before releasing production quantities.
- Keep the offshore line warm through one full demand cycle. Dual-running costs inventory but removes the risk of a stockout during ramp.
- Confirm tooling ownership and removal rights in writing before any tool moves; unclear tool ownership is the single most common reason a transfer stops mid-way.
Budget eight to sixteen weeks for qualification on a molded part with existing tooling, and four to eight weeks for machined or assembled products. Related reading: our guide to the contract manufacturing process and design for manufacturing.
Frequently asked questions
What are the benefits of reshoring?
Reshoring shortens lead times from months to weeks, removes ocean freight and tariff exposure, improves quality control through proximity, strengthens IP protection under enforceable domestic contracts, frees working capital by shrinking in-transit and safety stock, and lets engineering changes reach production far faster.
Is reshoring more expensive than offshoring?
The unit price is usually higher, but total landed cost is often comparable or lower once freight, duties, inventory carrying cost, quality escapes, travel and oversight are included. Products with high shipping volume, frequent design changes or volatile demand tend to favor domestic production.
How long does it take to reshore manufacturing?
An assembly-only transfer can be completed in three to six months. A molded or electromechanical product typically takes six to eighteen months, driven by tooling transfer or rebuild, supplier qualification and pilot production.
What does reshoring cost?
Transfer costs range from roughly $10,000 to $50,000 for simple assembly, $25,000 to $150,000 when existing tooling can move, and $60,000 to $400,000 when new tooling is required. Payback commonly falls between twelve and thirty-six months.
When should you not reshore?
Keep production offshore when the product is labor-dominant with a mature, stable design, when the component ecosystem is physically clustered overseas, when you are serving that regional market directly, or when no domestic supplier can run the required process at your volume.
What is the difference between reshoring and nearshoring?
Reshoring returns production to your own country. Nearshoring moves it to a nearby country, such as Mexico or Canada for a US company, capturing most of the lead-time and oversight benefits at a lower labor rate while keeping some cross-border complexity. Work with LA NPDT: if you are moving from here to execution, start with our low-volume manufacturing or talk to us about design for manufacturing .
